How Long Does Load Bearing Wall Removal Take? Week-by-Week Timeline

The physical wall removal itself, the part most homeowners picture when they think about this project, is often the fastest stage of a load bearing wall removal, typically 1 to 2 days. What takes longer is everything around it: engineering, permit review, and inspections. This guide walks through the realistic full timeline, not just the demo day.

Week 1-2: Structural Assessment and Engineering Drawings

A structural engineer visits the home, confirms the wall's load bearing status, calculates the load it's carrying, and specifies the beam, posts, and any footing requirements. This produces the stamped drawings the permit application depends on.

Week 2-5: Permit Application and Review

The engineered drawings are submitted to the City of Toronto for review. This is typically the longest stage of the whole process, and the timeline can extend if the initial application generates revision requests. See our full breakdown of permit application and review for what the City actually requires.

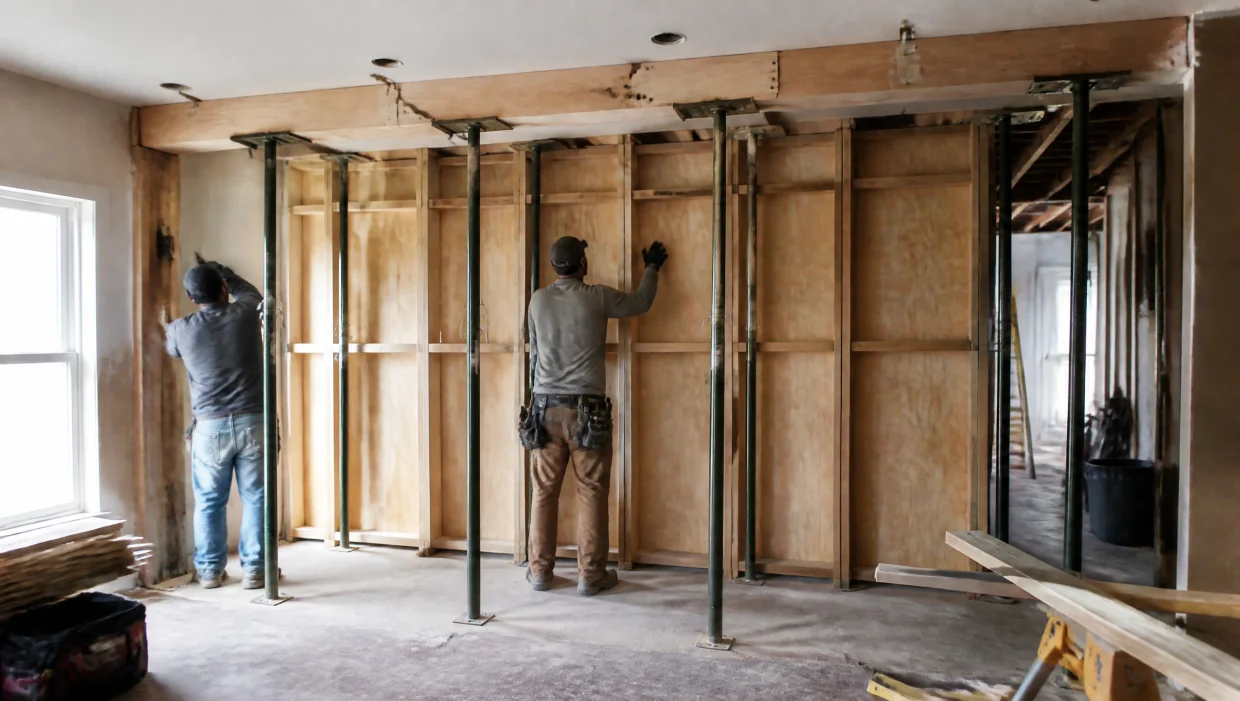

Day 1: Temporary Shoring

Once the permit is approved, temporary support walls or adjustable steel posts go in on either side of the wall being removed, carrying the load safely while the permanent beam is installed.

Day 1-2: Demolition and Beam Installation

The wall comes out, the permanent beam is lifted into position and secured, and posts are placed to carry its load down to proper support. See our detailed walkthrough of demolition and beam installation for what actually happens on-site during this stage.

Framing Inspection

A City inspector reviews the new beam and post installation while it's still visible, confirming it matches the approved engineering drawings before drywall closes it up.

Day 3-5: Finishing Work

Drywall, ceiling patching, and paint complete the visible transformation, though this stage's duration varies significantly depending on the overall scope of the finishing work involved.

Final Inspection and Permit Close-Out

Once all work, including finishing, is complete, a final inspection confirms everything matches the approved plan and formally closes out the permit.

Real project example: A recent BaseWorks single-storey load bearing wall removal in an East York semi-detached home took just under 3 weeks from initial engineering visit to final inspection sign-off, with the physical demolition and beam installation itself completed in a day and a half.

What Speeds This Up

  • A complete, accurate initial permit application, reducing revision cycles with the City
  • Good site access for equipment needed during demolition and beam installation
  • Existing basement support already in a useful location, simplifying the load transfer path

What Slows This Down

  • Permit revision cycles triggered by an incomplete or unclear initial submission
  • Discovering unexpected conditions once the wall is opened, such as plumbing or electrical rerouting needs
  • Undersized existing footings requiring additional structural work beyond the original scope

Why the Wall Comes Out Fast but the Project Takes Weeks

Many people picture the project as the demolition, and then are surprised to learn it takes several weeks. The reason is that demolition is the only stage where the work happens on site and at speed. Everything that makes the work safe and legal is slower and happens elsewhere.

The engineering has to be done properly before the permit can be applied for, because the City reviews the calculations, not just the idea. The City's review is a queue, and you cannot move it forward, although you can avoid sending it backward by submitting a complete application. After the permit comes the physical work, which is a day or two of demolition and beam installation, followed by an inspection while the structure is still exposed. Only then do the finishing trades close it up. Most of the calendar time is therefore paperwork and verification, not construction, and that is by design: the checkpoints are what make the finished wall trustworthy.

Who Does What at Each Stage

It helps to know who is responsible at each phase, since it tells you whom to ask when something slips.

  • Assessment and engineering. The engineer visits, calculates the load and prepares the stamped drawings. You provide access and answer questions about the layout.
  • Permit application. The contractor, usually with the engineer, prepares and submits the package. You sign where required.
  • City review. The City reviews and may request revisions. The contractor and engineer respond.
  • Shoring, demolition and beam installation. The contractor's crew does the work. You prepare the space and stay out of the work area.
  • Framing inspection. The contractor books the City inspector and is present. Nothing is closed up until it passes.
  • Finishing. The contractor or finishing trades complete drywall, paint and any flooring tie-ins. You choose finishes.
  • Final inspection and close-out. The City confirms the work and closes the permit. You keep the records.

Your own decisions, such as paint colours, flooring and lighting, are the part most likely to affect the finishing schedule, so making them early keeps things moving.

Single-Storey and Two-Storey Projects Compared

The timeline above describes a typical single-storey removal, with a real example completing in just under three weeks from the first engineering visit to final sign-off. A two-storey load transfer follows the same stages, but several of them can take somewhat longer.

The reason is the load. A wall supporting two floors, or a floor and a roof, carries more weight, which usually means a larger beam, stronger posts and a more demanding check of the footings underneath. The engineering takes more effort, the drawings are more detailed, and the City's review can be more thorough. On site, a bigger beam may need mechanical lifting, and the temporary shoring has to be more substantial. None of this changes the order of events, but each stage tends to have a little less slack.

If you are combining the wall removal with other structural work, such as underpinning the basement beneath it, the sequencing becomes part of the plan. Our guide to combining wall removal with basement underpinning explains how the two fit together.

Planning the Schedule Around Your Life

A project that takes weeks has to fit around the rest of your life, so a few practical choices are worth making in advance.

  • Pick a season and an event. If you want the space ready before a holiday or a family event, work backwards from that date, and add a buffer.
  • Coordinate other work. If you are also replacing flooring, lighting or a kitchen, ask how the trades will be sequenced so nothing is installed and then torn out.
  • Decide on finishes early. Paint, trim and flooring choices should be settled before the finishing phase starts.
  • Leave time for the unexpected. Plumbing or wiring found in the wall, or a revision request from the City, can add days.
  • Keep the records. The permit, drawings and inspection sign-off matter long after the dust has settled.

For the cost side of the same project, see our load bearing wall removal cost guide, and for the service itself, see our load bearing wall removal page.

What a Delay Looks Like, and How to Handle It

Even a well-run project can slip, and it helps to know what that usually looks like. The most common cause is a revision request from the City, where a reviewer asks for a clarification or a missing detail. The contractor and engineer respond, the application goes back into review, and that round typically adds a week or more to the permit stage.

A second common cause is a surprise inside the wall, such as plumbing, wiring or a duct that was not on any drawing, which has to be rerouted before the work can continue. A third is simply a finishing trade that is not available on the day you expected. In each case, the right response is the same. Ask for the new date in writing, ask whether anything else in the schedule moves as a result, and adjust your own plans, such as flooring delivery or a move-in date, rather than rushing the work. A contractor who tells you about a delay the moment they know is far easier to work with than one who lets you find out later.

Frequently Asked Questions

Can the wall removal happen before the permit is approved?

No. Since this is structural work, the permit needs to be approved before demolition begins. Starting without an approved permit risks a stop-work order mid-project, which typically costs more time overall than waiting for approval in the first place.

How long am I without a functional living space during demo?

The physical demolition and beam installation itself typically runs 1 to 2 days, though the affected room stays under construction, with dust protection and temporary shoring visible, through the finishing phase as well. Most of the rest of the home remains fully usable throughout.

Does a two-storey load transfer take longer than a single-storey one?

Generally yes, since a two-storey load transfer often involves a larger beam, more complex post and footing requirements, and sometimes more extensive engineering review. The core process stages are the same, but each one can take somewhat longer for a heavier load.

Can I speed up the permit review myself?

The most effective way to avoid delays is submitting a complete, accurate application with clear engineering drawings the first time, since incomplete applications are what typically trigger the longest delays through revision cycles. Beyond that, review timing is largely outside your direct control.

How soon after the beam is in can I paint and install flooring?

Once the framing inspection has passed and the wall cavity is closed, the finishing trades can start. Drywall and patching come first, followed by priming and paint, and flooring tie-ins usually come last. The exact sequence depends on how much of the room is being refinished.

Does the timeline include a kitchen renovation if I am opening the wall into the kitchen?

No. The timeline covers the structural removal and the finishing needed to close the opening. A kitchen renovation is a separate project with its own schedule, so ask your contractor how it should be sequenced relative to the wall work to avoid doing anything twice.

Know Exactly What to Expect

BaseWorks gives you a clear day-by-day schedule before work starts - no surprises, no open-ended timelines.

Get Your Free Estimate
Free Estimate - No ObligationToronto & GTA Basement Specialists
Call Now Get Quote
